Hwy 30 Reconstruction

Rushford

About this project

Summary of work

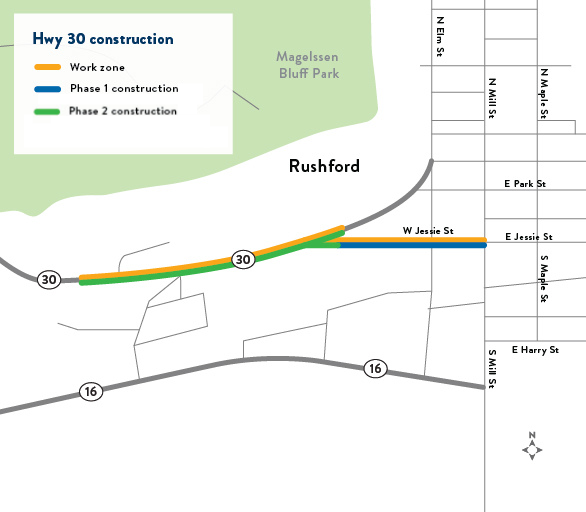

Hwy 30 project map
Hwy 30 project map

In 2022, 0.55 miles of Hwy 30 were reconstructed from the west side of Rushford to Hwy 43. Construction began May 9 and was completed mid-November.

Work included the following:

  • Reconstructed Hwy 30 from western city limits to Hwy 43 (Mill St.), including curb and gutter.
  • Replaced existing sidewalk and extended sidewalk west to Southview Ct.
  • Replaced storm sewer pipe and structures.
  • Improved downtown lighting.
  • Reconstructed city sanitary sewer, water main, and services.

The project was split into two construction phases.

  • Phase 1: Downtown/east end
    • Work zone: Mill St./Hwy 43 to W Stevens Ave.
    • Planned schedule: May 9 to August 2022
  • Phase 2: Residential/west end
    • Work zone: W Stevens Ave. to western city limits
    • Planned schedule: Week of July 11 to late October 2022

Traffic impacts

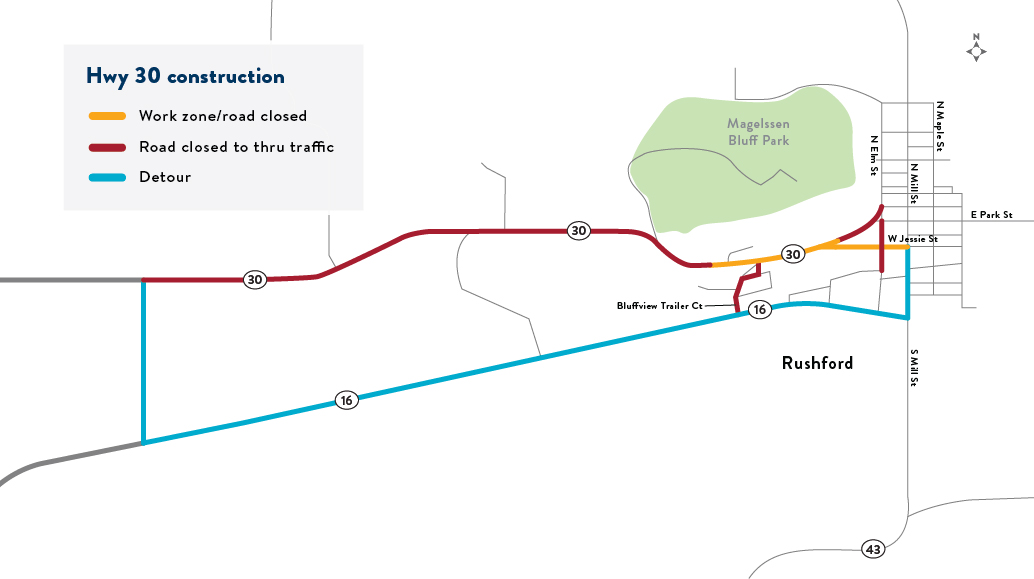

Hwy 30 detour map
Hwy 30 detour map

No traffic impacts - project is complete.
